Budgetary Quote: Meaning, Example and How It Differs from a Firm Quote
A budgetary quote is a supplier's planning price, not meant to be accepted as an order. What it means, how it differs from a firm quote, how to ask for one and a worked example.

A budgetary quote is a supplier's approximate price for planning: a fair number, given on limited information, that neither side expects an order to be placed against. It is also called a budget quote, budgetary quotation, budgetary offer or budgetary price. A firm quote is different: it is an offer you can accept, with a defined scope, price, delivery, terms and validity period.
In short, a budgetary quote helps you set a budget, and a firm quote tells you what the supplier will supply, at what price and on what terms, if you order in time. The two numbers for the same item often differ, usually because the firm one includes scope the budget never contained. Treat the first like the second and your estimate, your schedule or your contract will catch you out.
Why this matters now
Most capital projects collect both kinds of quote, months apart, for the same equipment. Budgetary prices feed the early estimate. Firm quotes arrive when the datasheets, the documents that fix each item's duty, materials and design, are frozen and the project is ready to buy.
The gap between them is often large, and it is usually not the supplier putting the price up. It is scope becoming real: materials of construction, seals, testing, documentation and delivery terms that were never in the first number. AACE International, a professional body for cost engineering, ties estimate accuracy to how mature the project definition is. Its ranges run from as wide as 50% below to 100% above at Class 5, the earliest estimate, down to roughly 10% to 20% below and 10% to 30% above at Class 3, the estimate usually used to approve spending [1]. In practice, replacing budgetary prices with firm ones on the main equipment is a big part of that move.
Volatile material costs make the distinction sharper. Outokumpu, for example, prices stainless steel as a base price, extras and an alloy surcharge, and usually publishes the surcharge month by month to pass on changes in alloy costs [2]. A price that was right in March may not be right in September.
Create and manage RFQs in minutes
ChemCapital handles the entire procurement cycle, from structured RFQs and supplier comparisons to formal purchase orders and delivery tracking.
Budgetary quote vs firm quote: what each commits you to
| Budgetary quote | Firm quote | |
|---|---|---|
| Purpose | Estimating and feasibility | Placing an order |
| Basis | Duty point or outline scope | Frozen datasheet and specification |
| Typical content | One price, a rough lead time | Scope, exclusions, delivery terms, lead time, payment, warranty |
| Validity | Often not stated | Stated, often short for alloy equipment |
| Can you accept it? | Not intended to be | Intended to be, on its terms |
| Where it belongs | Class 4 and 5 estimates | Class 3 estimates and the purchase order |
Whether a quote commits anyone depends on more than its label. In English law, for example, the UK Supreme Court has held that whether a binding contract exists, and on what terms, depends on what the parties communicated by words or conduct, judged objectively [3]. Labels such as "subject to contract" count, but conduct can override them, as it did in that case. So a budgetary quote that names a scope, a price and a delivery date and says "valid for eight weeks" starts to look like an offer. A firm quote that says "subject to final engineering review" starts to look like it is not. Other legal systems have their own rules, so check how yours treats quotations. This is general information, not legal advice.
What is budgetary pricing?
Budgetary pricing means giving, or asking for, prices that are good enough to plan with but not to buy against. The supplier works from limited information: usually a duty point (the flow, pressure, temperature and fluid the equipment must handle) or an outline scope, plus its experience of similar jobs. It does little or no detailed engineering, and it makes assumptions about anything you have not yet decided, such as materials, standards, testing and documentation.
Buyers and cost engineers use budgetary pricing to:
- build early cost estimates and business cases;
- compare options, such as two process routes or two types of equipment;
- set a realistic budget before a formal enquiry;
- decide which packages are big enough to need a full tender.
A budgetary price has no standard accuracy. Its value depends on how well the supplier understood the duty and how many assumptions it had to make. So the useful question is not how accurate the number is, but what it is based on. Budgetary price, budget price and budgetary pricing all describe the same idea.
Other names, and budgetary quote vs formal quotation
A budget quote, budgetary quotation, budgetary offer, budgetary price and indicative quote all mean a price for planning. A firm quote may also be called a firm quotation, a firm price, a formal quote or a formal quotation.
Formal and firm describe different things. Formal is about the process: a quotation sent in reply to a formal enquiry or request for quotation (RFQ), usually with a reference number, the supplier's terms and a validity period. Firm is about the commitment: the supplier will supply that scope at that price, on those terms, if you accept in time. A formal quotation is usually firm, but read it. A neatly presented document marked budgetary, or subject to final engineering, is usually still not firm, and a short email can be firm if it states scope, price, delivery and validity.
A budgetary estimate is something else again. An estimate is the buyer's own calculation, or its cost engineer's or contractor's, and it may combine budgetary quotes, firm quotes, historical prices and allowances. A quote, of either kind, always comes from the supplier.
How to ask for a budgetary quote, and how to read one
What to send
A budgetary quote is only as good as the information behind it. Send enough for the supplier to price the right item, and no more than the estimate needs:
- the duty point or outline scope, with the fluid and its properties;
- materials and design code if you know them, or a note that they are still open;
- quantity, including installed spares such as duty and standby pumps;
- the site location and the delivery basis you would like priced;
- the testing and documents you expect, if known;
- when you expect to buy, and a clear statement that the request is for budget purposes.
Pricing a budget enquiry takes the supplier's time, so be honest about where the project stands, and do not use a budget request to get free engineering.
Model wording
We are preparing an early cost estimate for a new solvent recovery unit and would welcome a budgetary quote for the pump described below. This is for budget purposes only and is not an order or a formal enquiry. Please state what your price includes and excludes, the materials and delivery terms you have assumed, and an approximate lead time from order. We expect to issue a formal enquiry in [month] and would value your reply by [date].
When the project is ready to go firm, our RFQ template for process equipment sets out a fuller request.
What is usually missing
A budgetary quote is usually short, so read it for what it leaves out:
- Assumed materials. The price may assume a standard material such as carbon steel when you will need stainless steel or an alloy.
- Ancillaries. Seals and seal support systems, instruments and controls may sit outside the price.
- Testing and inspection. Witnessed tests, which you attend at the supplier's works, are often extra.
- Documentation. Certificates, drawings and data books are often not priced.
- Delivery. The price is often ex works, meaning you collect from the supplier's factory, with no freight included.
- Validity, lead time and price adjustment. Often missing or rough. The next section covers them.
Where the supplier lists its assumptions, keep them with the number. Where it does not, write down your own reading of the basis, so the gaps are visible when the firm quote arrives.
A budgetary quote earns its place in early estimates; firm prices replace it before the estimate is used to approve spend.
The terms that decide the real price
When a firm quote arrives, these lines matter as much as the headline number:
- Exclusions. Commissioning, site supervision, spares, special tools and documentation are the usual gaps.
- Delivery terms. The Incoterms 2020 rule on the quote, one of the International Chamber of Commerce's standard trade terms, sets who pays for transport and who carries the risk on the way [4]. An ex works price and a delivered price are not comparable until freight is added. Our guide to Incoterms for process equipment goes further.
- Lead time basis. Weeks from order and weeks from drawing approval are not the same clock, and on engineered items the gap is often several weeks.
- Price adjustment. Check for alloy surcharge clauses and escalation formulae, and the date they are calculated on.
- Validity. Note whether price, lead time and surcharge each have their own validity. They often do.
Whose terms win: an English law example
When your purchase order says one thing and the supplier's quote or acknowledgement says another, lawyers call it a battle of the forms. English courts usually look at the sequence of offer, counter offer and acceptance. In one Court of Appeal case, a supplier's acknowledgement that was "subject to" its own terms counted as a counter offer, and the buyer accepted it by going ahead with the deal, so the supplier's terms applied [5]. Other legal systems have their own rules, but the practical lesson is worth following anywhere: read the acknowledgement, and reject conflicting terms in writing before work starts.
This is general information, not legal advice. For anything with real money at stake, ask your legal team.
Practical example

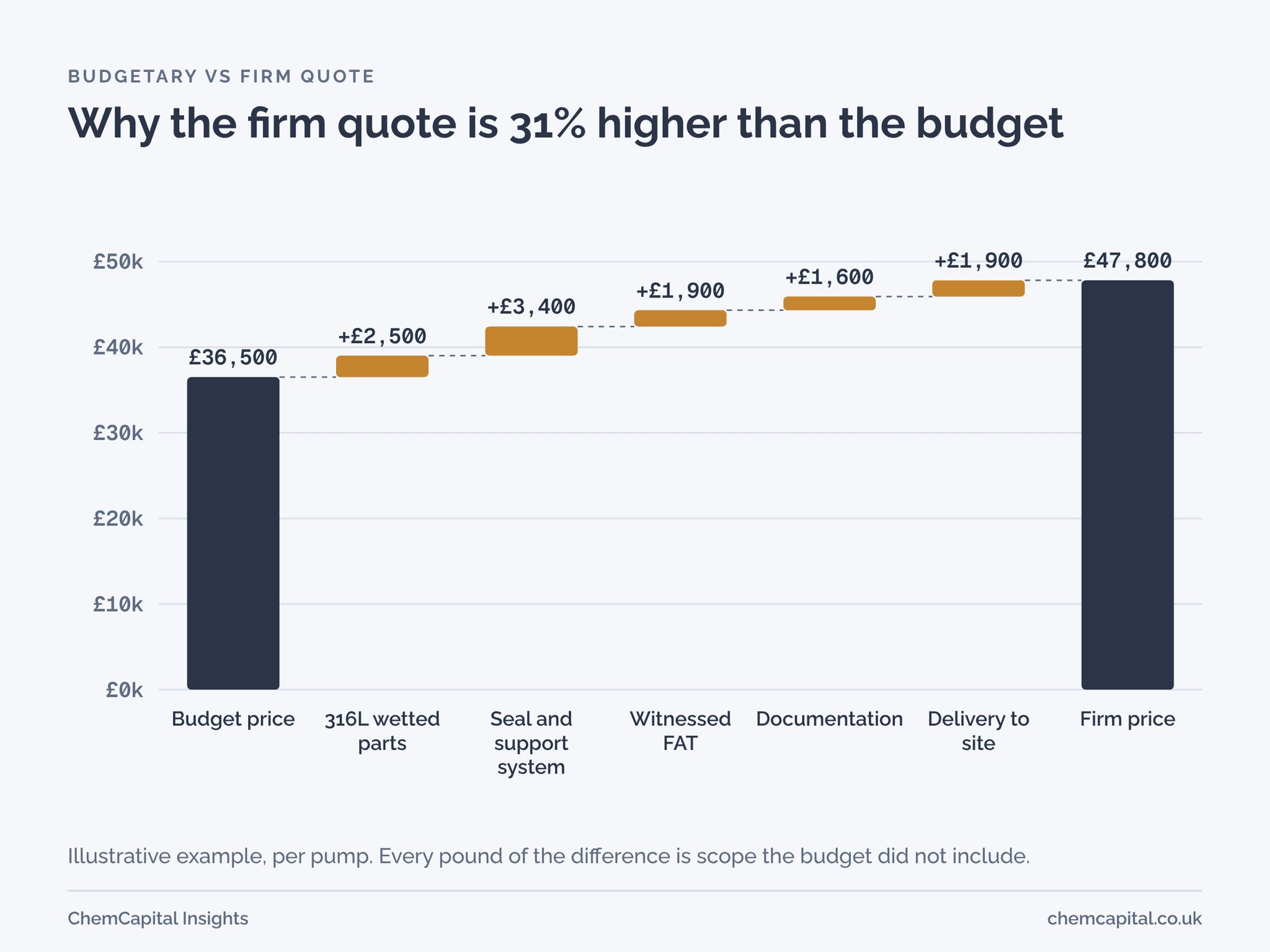

In March, a project team asks for budget prices on two process pumps, P101A/B, for a feasibility estimate. In September, with the datasheet frozen, the same supplier sends a firm quote. The figures are illustrative, and the pattern is the same in any currency.
| Line, per pump | Budgetary (March) | Firm (September) |
|---|---|---|
| Pump and motor | £36,500, carbon steel assumed | £39,000, 316L wetted parts |
| Mechanical seal and seal support system | Not included | £3,400 |
| Witnessed factory acceptance test | Not included | £1,900 |
| Documentation package | Not included | £1,600 |
| Delivery | Ex works | £1,900, delivered to site |
| Total | £36,500 | £47,800 |
| Validity | Not stated | 30 days |
| Lead time | About 16 weeks | 22 weeks from drawing approval |
Read with the list above, the March quote showed every gap: carbon steel assumed, no seal system, no witnessed test, no documents and an ex works price. The firm price is 31% higher, and every pound of the difference is scope the budget never contained. For the pair of pumps, the line in the estimate moves from £73,000 to £95,600.
The lead time changed clock as well as length. About 16 weeks was a rough figure; 22 weeks runs from drawing approval, which comes after the order. And with 30 days' validity, the team has a month to place the order or ask the supplier to revalidate the price.
The mistake is not the budget quote. The mistake is carrying £36,500 into a Class 3 estimate as if it were firm.
Label every price by what it is
The simplest fix is discipline: every price in an estimate carries its basis, its date and its source, and budget numbers are replaced by firm ones before the estimate is used to approve spend. For the wider picture of estimate maturity, see our guide to AACE estimate classes.
That is how ChemCapital's Project Costing works. Each line is marked as a firm quotation, a budgetary quote, a historical quote adjusted for currency, date and location, or an indicative figure, so anyone reading the total can see what it rests on, and contingency is linked to how mature the estimate is. When a budgetary line needs to go firm, it becomes an RFQ in one click. A structured RFQ sends every supplier the same specification, quantities, delivery dates and deadline at once, and suppliers can quote budgetary or firm with line items, assumptions and attachments in one form, so the answers can be compared on one basis.
Ready to get firm, comparable quotes on your next package? Start a free 14 day ChemCapital trial, with no credit card needed.
Frequently asked questions
What does budgetary quote mean?
A budgetary quote is a supplier's approximate price, given on limited information, to help a buyer set a budget or build an early cost estimate. It is not meant to be accepted as an order, and it usually leaves out scope, terms and a validity period that a firm quote would state.
What is the difference between a budgetary quote and a firm quote?
A budgetary quote is a planning price that neither side expects an order against, while a firm quote is an offer with a defined scope, price, delivery, terms and validity that you can accept. The two prices often differ, usually because the firm quote includes scope, such as materials, testing and freight, that the budget left out.
What is budgetary pricing?
Budgetary pricing means prices good enough to set a budget or compare options, but not to buy against. Suppliers base them on a duty point, an outline scope or similar past jobs, so record the basis and date of every budgetary price you use.
Is a budgetary quote legally binding?
Usually not, because it is not meant to be accepted. In English law, for example, whether a binding contract exists depends on what both sides communicated by words or conduct, judged objectively, so a detailed quote with a price, delivery date and validity can start to look like an offer. This is general information, not legal advice.
